Home About Us Services ↳ Canada PR Visa (Permanent Residency) ↳ Work Permit Canada ↳ LMIA — Labour Market Impact Assessment ↳ Spouse & Family Sponsorship Visa ↳ Student Visa Canada ↳ Visitor Visa ↳ Business Visa Provinces ↳ 🏙️ Ontario ↳ 🏔️ British Columbia ↳ 🌾 Alberta ↳ 🌻 Saskatchewan ↳ 🌊 Manitoba ↳ ⚓ Nova Scotia ↳ 🍁 New Brunswick ↳ 🦞 Prince Edward Island ↳ 🐟 Newfoundland & Labrador ↳ 🌊 Atlantic Immigration Program Healthcare Blog FAQ Careers Canada Contact

April 1 to June 30, 2026: Quarterly progress report update on the Centre Block project

We're restoring and modernizing the Centre Block. We're also designing and building the Parliament Welcome Centre (PWC). It's the largest and most complex heritage rehabilitation ever seen in Canada. We estimate the cost to be between $4.5 billion and $5 billion. We aim to complete main construction between 2030 and 2031. The Centre Block will reopen about 1 year later. This will allow Parliament to do testing and get the building ready for operations.

On this page

Project health

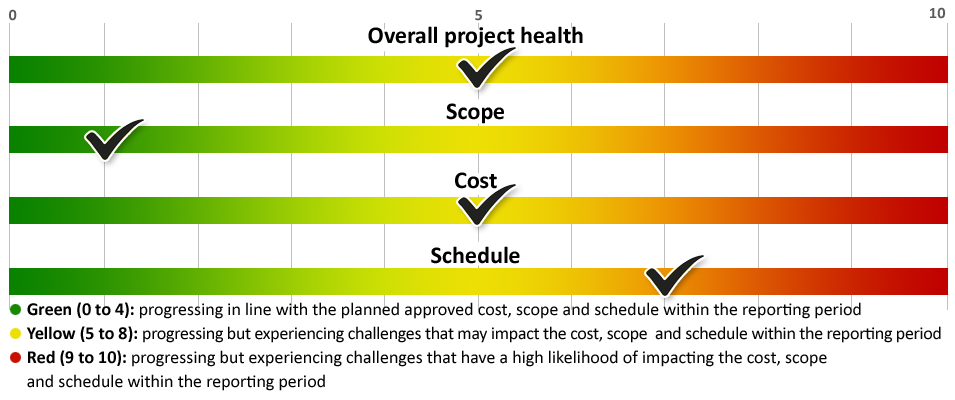

The following graph provides an overview of the project health based on approved cost, scope, and schedule, each ranging from 0 (low impact of affecting the project) to 10 (high impact of affecting the project), within the quarterly reporting period. The Long Term Vision and Plan annual reports provide an assessment of the overall project health.

Description below
Text version for project health graph

Project health is represented by 3 elements: scope, cost and schedule. Each element's status ranges from 0 to 10, where:

  • 0 to 4 represents the project progressing in line with the planned approved cost, scope and schedule within the reporting period
  • 5 to 8 represents the project progressing but experiencing challenges that may impact the cost, scope and schedule within the reporting period
  • 9 to 10 represents the project progressing but experiencing challenges that have a high likelihood of impacting the cost, scope and schedule within the reporting period

Current status:

  • Overall, the project is progressing in line with the planned approved cost, scope and schedule with a rating of 5
  • Scope is in line with the planned approved scope with a rating of 1
  • Cost is in line with the planned approved cost at a rating of 5
  • Schedule is in line with the planned approved schedule with a rating of 7

Construction progress

An update on current construction activities for the Centre Block project.

Parliament Welcome Centre

The construction of levels 2 and 3 is approximately 75% complete. The project remains on schedule to finish pouring both levels by the end of 2026.

Status: On track

Main excavation: Complete

Geo-exchange wells: Complete

Structural build: 40% complete

Centre Block: Upper Levels

Throughout the Centre Block, we continue to brace, remove and rebuild the upper floors for a stronger, safer, more resilient building.

The Peace Tower now has a new foundation. This new base slab is secured to the main level of the building.

Status: On track

Structural rebuild: 37% complete

Centre Block: Basement Levels

Excavation continues in the west and east courtyard areas for the new Centre Block basement levels. This complex work is progressing carefully to preserve the structural and heritage aspects of the upper floors.

Status: On track

Basement excavation: Approximately 3,300 truckloads

Centre Block: Exterior

Masonry work has started in all courtyards, starting with dismantling the walls.

Installation of scaffolding along the south façade is scheduled to be complete by the end of 2026.

Status: On track

Overall masonry: Approximately 26% complete

Overall roof removal: Approximately 35% complete

Cost update

Spending to date on the Centre Block project is approximately $1.790 billion.

The overall budget was established based on a cost report completed in 2021. The report was provided by an independent consultant who validated the method we used to establish cost for the construction.

Centre Block project due diligence report: Cost report

Dollars spent against dollars budgeted (in billions of dollars)

Financial data as of June 15, 2026

Description below
Text version of Dollars spent against dollars budgeted graph
Spent against budget
Item Spent to date Budget
Centre Block and Parliament Welcome Centre $1,790,000,000 $4,500,000,000 to $5,000,000,000

Note

Please refer to Annual reports: Long Term Vision and Plan for the Parliamentary Precinct for expenditures related to the overall project.

Key milestones

The following timeline illustrates the major milestones we are working on this year.
Checkmark= Completed; Circle= In progress

2030 to 2031

  • In progress: Complete main construction

2027

Winter

  • In progress: Award the contracts to rebuild the roof
  • In progress: Commence procurement for the new skylights in the west and east courtyards
  • In progress: Complete 25% of the roof level structure in the PWC
  • In progress: Complete 75% of the basement level 1 concrete slab in the PWC
  • In progress: Commence installation of PWC mechanical, electrical, and plumbing floor rough-ins

2026

Winter

  • Completed: Completed 55% of the level 1 concrete slab rebuild
  • Completed: Completed 75% of the erection of the south façade scaffolding
  • Completed: Concluded construction of a new underground duct bank across the front lawn, with landscape reinstatement to follow in spring 2026
  • Completed: Finished pouring the foundation footings for the PWC

Spring

  • Completed: Strengthened the foundation of the Peace Tower structure
  • In progress: Started installation of the 100% Canadian steel frame around the Peace Tower to support exterior construction activities
  • Completed: Commenced the removal of the masonry in the west and east courtyards as part of the masonry restoration scope
  • Completed: Completed offsite restoration of the carillon, including all components and the keyboard (completed ahead of summer 2026 targets)

Summer

  • In progress: Install 85% of the temporary roof enclosures to support the build of the new roofs
  • In progress: Start the construction of the new roofs and the top level
  • In progress: Finish 75% of the level 1 concrete slab rebuild
  • In progress: Finish 75% of the basement level 2 concrete floor in the PWC
  • In progress: Complete approximately 30% of the basement level 1 concrete slab of the PWC

Fall

  • In progress: Start the floor rebuild in the Chambers, beginning with the removal of the original floor
  • In progress: Finish the off-site restoration of 5 of 14 frescoes from the Leader of the Opposition’s office
  • In progress: Complete over 50% of the basement level 1 concrete slab in the PWC
  • In progress: Finish the basement level 2 concrete slab in the PWC
  • In progress: Complete approximately 50% of the floor removals as part of the upper-level floor rebuild process

2025

Winter

  • Completed: Completed 100% of the design development for the landscape
  • Completed: Completed 95% of the targeted 100% of the drilling of support posts in the Centre Block basement
  • Completed: Completed the restoration of the 22 carillon bells
  • Completed: Completed about 33% of the targeted 50% of the level 1 concrete slab rebuild
  • Completed: Started rebuilding the sloped (mansard) roof, starting on the west side
  • Completed: Installed the second tower crane in the middle of the PWC excavation site

Spring

  • Completed: Began excavating the Centre Block basement levels, starting in the west courtyard
  • Completed: Completed scaffolding in the east courtyard, which will support exterior work and the rebuilding of the sloped (mansard) roof
  • Completed: Started building scaffolding on the south façade
  • In progress: Complete Centre Block and PWC design engagements and finalize decisions to complete the design development in fall 2025
  • Completed: Started construction of a new underground duct bank across the front lawn to relocate and upgrade existing infrastructure for future Parliament Hill use (to avoid disruptions during busy summer periods, this work will be done in phases, starting from the west side)
  • Completed: Installed the third tower crane on the east side of the PWC excavation site to support the ongoing construction

Summer

  • Completed: Started restoring the fresco paintings for future reinstatement in the Leader of the Opposition's office
  • Completed: Began restoring heritage woodwork from the Pearson Special Heritage rooms
  • Completed: Started restoring heritage marble flooring and wainscotting
  • Completed: Finished removing the copper roof on the northwest side
  • Completed: Demolished 3 of the planned 4 elevator penthouses in preparation for rebuild
  • Completed: Began transferring the building's weight onto structural posts to prepare for excavation, starting on the east side (originally planned for fall 2025)
  • Completed: Completed approximately 50% of the basement footings and 25% of the basement level 3 (the lowest level) concrete slab of the PWC to improve construction sequencing

Fall

  • Completed: Finalized design development for the Centre Block and PWC
  • Completed: Completed approximately 50% of the basement level 3 concrete slab of the PWC
  • Completed: Finished drilling 100% of the support posts in the Centre Block basement
  • Completed: Substantially completed exterior masonry restoration on the west and east façades
  • Completed: Began construction of new concrete slabs on levels 5 and 6
  • Completed: Removed about 15% of the roof in preparation for rebuilding

2024

Spring

  • Completed: Started the contracting process for the Centre Block's replica windows
  • Completed: Completed 20% of the 100% target of temporary concrete shear walls to support the Centre Block during excavation work
  • Completed: Completed 20% of the 25% target of the level 1 concrete slab rebuilding
  • Completed: Started the contracting process for the new PWC's structural build scope

Summer

  • Completed: Completed west façade and west courtyard scaffolding, which will be used to support exterior work and the rebuilding of the sloped (mansard) roof
  • Completed: Started structural work on levels 1 to 6 of the Centre Block
  • Completed: Completed about 25% of the level 1 concrete slab rebuilding

Fall

  • Completed: Completed construction documents for the Centre Block's sloped (mansard) roof
  • Completed: Completed the remaining temporary concrete shear walls to support the Centre Block during excavation work
  • Completed: Completed about 30% of the 40% of the level 1 concrete slab rebuilding
  • Completed: Started the structural build of the PWC

2023

Winter

  • Completed: Began drilling geo-exchange wells for the PWC
  • Completed: Began installing temporary posts to support the basement excavation
  • Completed: Began scaffolding work on the east façade
  • Completed: Completed main excavation for the PWC

Spring

  • Completed: Began repairing masonry on the east façade
  • Completed: Began removing and replacing the structural floor slab on level 1
  • Completed: Installed decorative tarps on the east façade
  • Completed: Obtained federal land use approval of the landscape design

Summer

  • Completed: Began restoring the 22 carillon bells and keyboard that were transported to the Netherlands
  • Completed: Began scaffolding work on the west façade
  • Completed: Completed the drilling of geo-exchange wells south of the PWC (accounts for about 45% of the wells)
  • Completed: Completed the demolition and abatement of the Senate Chamber and dining room
  • Completed: Excavated for the future connection to phase 1 of the Visitor Welcome Centre

Fall

  • Completed: Began excavation for the northeast section of the PWC
  • Completed: Began repairing the masonry on the west façade
  • Completed: Installed decorative tarps on the west façade
  • Completed: Substantially completed the demolition and abatement
  • Completed: Started the contracting process for elevators and escalators for both buildings
  • Completed: Completed 50% of the design development for the landscape
  • Completed: Restored 50% of the stained glass windows

2022

Spring

  • Completed: Finalized schematic design

Summer

  • Completed: Obtained federal land use approval of schematic design
  • Completed: Began installing structural support to excavate the basement

Fall

  • Completed: Began conserving heritage assets
  • Completed: Began detailed excavation for the Parliament Welcome Centre (PWC)
  • Completed: Completed masonry repairs on the north wall façade

2021

Spring

  • Completed: Approved cost, scope and schedule

Project spotlight

Each quarter, we highlight an element of work being done on the Centre Block project.

Restoring the Speakers’ dining rooms

When architects John A. Pearson and J. Omer Marchand re-designed the Centre Block after a fire destroyed the original building in 1916, they included approximately 50 special heritage rooms. This includes the Speakers’ dining rooms, which are being carefully restored to reflect their original 20th-century designs while being adapted for modern use. The Speakers often host special events and important guests who are visiting Parliament, including foreign leaders, diplomats and Nobel laureates.

We are bringing back the architects’ vision to the Speakers’ dining rooms.

Senate Speaker’s dining room

Description below
Archival image.
Description below
New design render.

The Senate Speaker’s dining room will be restored to its original appearance, as layers of paint are removed from the ceiling plasterwork to reveal its exceptional details.

House of Commons Speaker’s dining room

Description below
Archival image.
Description below
New design render.

The House of Commons Speaker’s dining room will be restored to include many original details, such as the gold ceiling, cove details and previously covered stencil details on the walls.

Previous reports

Quarterly progress report on the Centre Block project

Related links

Page details

2026-07-08

Quick Enquiry

We usually reply within a few hours
By submitting you agree to be contacted about your enquiry.
Call us Chat on WhatsApp
M

Migova AI Assistant

Online now
Hi 👋 I'm the Migova AI assistant, powered by OpenAI. Ask me about PR, study visas, work permits, LMIA, family sponsorship, provinces, or healthcare immigration to Canada.
Canada PR
Study Visa
LMIA / Work Permit
